Old Hampden Improvements
The City of Englewood is making significant upgrades to Old Hampden Avenue to enhance its infrastructure and create a safer, more welcoming corridor for everyone. These improvements are being carried out in two major phases:
Phase 1: Utility Improvements (January–Fall 2025)
The first phase focuses on replacing aging underground water, sanitary sewer, and stormwater systems to ensure reliable service for years to come.
Learn more about Old Hampden Utility Improvements here.
Phase 2: Complete Streets Project (Fall 2025–Summer/Fall 2026)
The second phase redesigns Old Hampden above ground with ADA improvements, better sidewalks, upgraded bus stops, and traffic-calming features, creating a more accessible, safer environment for all travelers.
Learn more about Old Hampden Complete Streets here.
What to Expect During Construction
- Phase 1 Utility Improvements: Construction will occur in phases, with street closures impacting one or more blocks at a time.
- Phase 2 Complete Streets Construction: Through traffic is expected to remain open, but minor disruptions may occur during this phase.
Current Road Closures and Detours

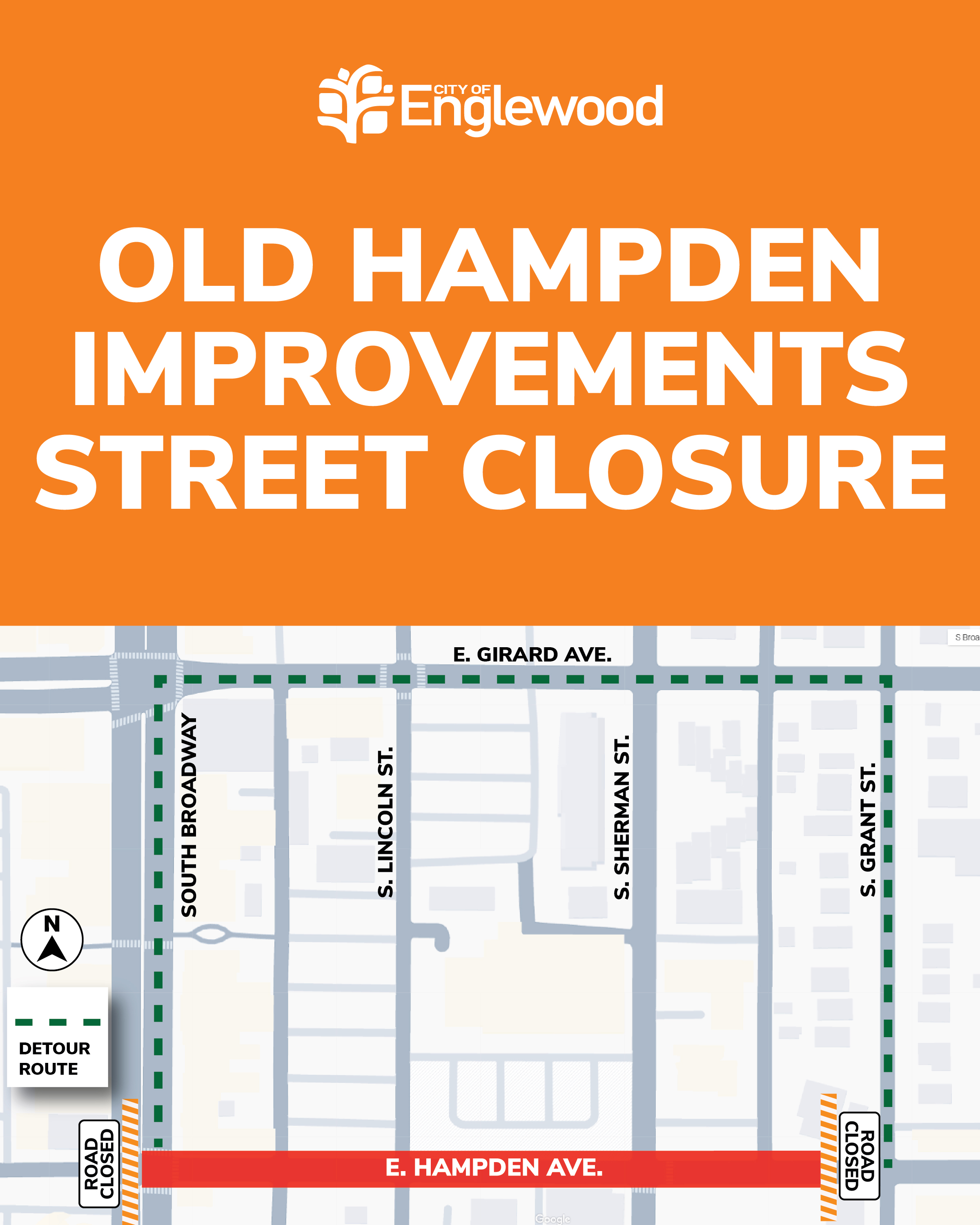

Work is progressing on the Old Hampden Utility Improvements Project. The current closure is on Old Hampden Avenue from South Pearl Street to South Washington Street and is expected to last until late August.
Crews will continue upgrading aging utility infrastructure along the corridor, including water and stormwater pipes originally installed in the 1950s. These systems are nearing the end of their useful life and have contributed to water main breaks and storm-related flooding in the area.
Public Transportation Detours
- RTD
Please see RTD’s route alerts page for information regarding RTD bus stop closures and detours in this area. RTD Service Alerts (external link). - bert Englewood Trolley
Due to construction along Old Hampden Avenue, Englewood’s free shuttle service through the Wellness District has been rerouted. View the latest detour map here
The City of Englewood is making significant upgrades to Old Hampden Avenue to enhance its infrastructure and create a safer, more welcoming corridor for everyone. These improvements are being carried out in two major phases:
Phase 1: Utility Improvements (January–Fall 2025)
The first phase focuses on replacing aging underground water, sanitary sewer, and stormwater systems to ensure reliable service for years to come.
Learn more about Old Hampden Utility Improvements here.
Phase 2: Complete Streets Project (Fall 2025–Summer/Fall 2026)
The second phase redesigns Old Hampden above ground with ADA improvements, better sidewalks, upgraded bus stops, and traffic-calming features, creating a more accessible, safer environment for all travelers.
Learn more about Old Hampden Complete Streets here.
What to Expect During Construction
- Phase 1 Utility Improvements: Construction will occur in phases, with street closures impacting one or more blocks at a time.
- Phase 2 Complete Streets Construction: Through traffic is expected to remain open, but minor disruptions may occur during this phase.
Current Road Closures and Detours
Work is progressing on the Old Hampden Utility Improvements Project. The current closure is on Old Hampden Avenue from South Pearl Street to South Washington Street and is expected to last until late August.
Crews will continue upgrading aging utility infrastructure along the corridor, including water and stormwater pipes originally installed in the 1950s. These systems are nearing the end of their useful life and have contributed to water main breaks and storm-related flooding in the area.
Public Transportation Detours
- RTD
Please see RTD’s route alerts page for information regarding RTD bus stop closures and detours in this area. RTD Service Alerts (external link). - bert Englewood Trolley
Due to construction along Old Hampden Avenue, Englewood’s free shuttle service through the Wellness District has been rerouted. View the latest detour map here
-
Old Hampden Improvements Utility Project Update
Share Old Hampden Improvements Utility Project Update on Facebook Share Old Hampden Improvements Utility Project Update on Twitter Share Old Hampden Improvements Utility Project Update on Linkedin Email Old Hampden Improvements Utility Project Update linkConstruction continues in the Phase 3 closure area from Pearl Street to Washington Street. During this time:
Access to 601 Hampden and the hospitals is being maintained via the drive lane from the east and Pennsylvania Street from the west.
Crews are actively working on the redundant water feed to the hospital to enhance system reliability.
Work in this area is expected to continue through late August 2025.
Additionally, Bid Schedule D work has been added to the contract, expanding the scope of the current project.
Thank you for your continued patience as we make these critical infrastructure improvements.
-
Bert Route Update - July 2025
Share Bert Route Update - July 2025 on Facebook Share Bert Route Update - July 2025 on Twitter Share Bert Route Update - July 2025 on Linkedin Email Bert Route Update - July 2025 linkDue to construction along Old Hampden Avenue, Englewood’s free shuttle service through the Wellness District has been rerouted.
Stop 12 has been temporarily moved to to the southwest corner of S. Washington Street and Old Hampden Avenue.
View the updated route at englewoodco.gov/bert
-
Old Hampden Utility Improvements – July 2025
Share Old Hampden Utility Improvements – July 2025 on Facebook Share Old Hampden Utility Improvements – July 2025 on Twitter Share Old Hampden Utility Improvements – July 2025 on Linkedin Email Old Hampden Utility Improvements – July 2025 linkWork is progressing on the Old Hampden Utility Improvements Project, and the next construction phase is scheduled to begin Tuesday, July 15.
The current closure from South Logan Street to South Pearl Street will reopen to traffic, and the closure will shift east, closing Old Hampden Avenue from South Pearl Street to South Washington Street.
Crews will continue upgrading aging utility infrastructure along the corridor, including water and stormwater pipes originally installed in the 1950s. These systems are nearing the end of their useful life and have contributed to water main breaks and storm-related flooding in the area.
-
Old Hampden Utility Improvements Timeline Extended
Share Old Hampden Utility Improvements Timeline Extended on Facebook Share Old Hampden Utility Improvements Timeline Extended on Twitter Share Old Hampden Utility Improvements Timeline Extended on Linkedin Email Old Hampden Utility Improvements Timeline Extended linkAs utility work continues along Old Hampden Avenue, the City of Englewood is adjusting the construction timeline to allow for a more efficient and coordinated approach. Multiple new phases will be added to the utility portion of the project, pending city council approval. This additional work ensures that the entire length of aged and decaying storm pipe will be replaced prior to the Complete Streets construction, reducing the risk of failure of old pipe under new improvements, limiting the need to revisit completed areas and minimizing disruption to surrounding businesses, hospitals and residents.
The Complete Streets streetscape improvements originally planned to begin this fall will now be postponed. The project is expected to go out to bid in November, with construction anticipated to begin in early spring 2026.
Complete Streets construction will now begin in 2026, in the meantime, utility crews will continue making progress in the corridor to support the upcoming improvements. Third-party utility and communication contractors will be in the area replacing and relocating lines to prepare for future construction.
Progress to Date:
- More than 600 linear feet of concrete stormwater box culvert installed
- Water main replacements completed between Logan Street and Pearl Street
- Ongoing progress on storm main upgrades and coordination east of Pearl Street
We appreciate your patience and understanding as we continue making vital infrastructure improvements. This expanded approach will help ensure long-term reliability, reduce future disruptions and set the stage for the upcoming Complete Streets transformation.
-
Old Hampden Utility Improvements Update – May 2025
Share Old Hampden Utility Improvements Update – May 2025 on Facebook Share Old Hampden Utility Improvements Update – May 2025 on Twitter Share Old Hampden Utility Improvements Update – May 2025 on Linkedin Email Old Hampden Utility Improvements Update – May 2025 linkThe City of Englewood’s contractor has completed the initial utility improvements along Old Hampden Avenue. Paving is scheduled this week, and the intersection at South Logan Street and Hampden is expected to reopen by Tuesday, May 20.
Crews have also made significant progress on storm main upgrades, replacing outdated corrugated metal pipe with more durable concrete box culvert.
Once the current storm main work wraps up, the closure along East Hampden will shift east. The next construction zone will close Hampden Avenue from just before South Pennsylvania Street to just before South Pearl Street. A single-lane closure will also begin just east of Pearl.
Hospital access will be maintained throughout the project. Please follow posted detour signs in the area.
-
Old Hampden Complete Streets Project Update - April 2025
Share Old Hampden Complete Streets Project Update - April 2025 on Facebook Share Old Hampden Complete Streets Project Update - April 2025 on Twitter Share Old Hampden Complete Streets Project Update - April 2025 on Linkedin Email Old Hampden Complete Streets Project Update - April 2025 linkThe city has received the 100% design plans from the consultant, Felsburg Holt & Ullevig. The City of Englewood Staff will review the final plans and provide feedback to FHU.
As this project is funded through a Denver Regional Council of Governments (DRCOG) grant, it requires a special sign-off process. Once approved by the Colorado Department of Transportation (CDOT), these finalized plans will be posted for contractors to submit bids in late spring/early summer. Construction is expected to begin in summer 2025 and continue through summer 2026.
Subscribe to this page for the most up-to-date project information and street closure information. Thank you for your patience as we work to improve Old Hampden Avenue and create a safer, more accessible corridor for all who live, work, and visit Englewood.
-
Detour Route Update – March 2025
Share Detour Route Update – March 2025 on Facebook Share Detour Route Update – March 2025 on Twitter Share Detour Route Update – March 2025 on Linkedin Email Detour Route Update – March 2025 linkThe Old Hampden Improvements Project is advancing, and traffic patterns have been updated to accommodate ongoing work in the area.
The intersection of Logan Street and Old Hampden Avenue will fully close again on Monday, March 3 as construction progresses. The closure on E. Hampden Avenue from S. Grant Street to S. Pennsylvania Street is estimated to last until early May.
These closures are essential for upgrading aging infrastructure and preparing the area for streetscape improvements aimed at enhancing public safety and accessibility.
-
Detour Route Update - February 2025
Share Detour Route Update - February 2025 on Facebook Share Detour Route Update - February 2025 on Twitter Share Detour Route Update - February 2025 on Linkedin Email Detour Route Update - February 2025 linkThe Old Hampden Improvements Project is progressing, and traffic patterns have been updated. Logan Street has reopened temporarily at Old Hampden, improving traffic flow while work continues in the area.
What to Expect:
Street closures will continue in phases along Old Hampden Avenue—please follow updated detour signs and allow extra travel time.
Logan Street at Old Hampden is expected to fully close again in March as construction advances.
These closures are essential for upgrading aging infrastructure and preparing the area for streetscape improvements aimed at enhancing public safety and accessibility.
-
Bert Shuttle Route Update
Share Bert Shuttle Route Update on Facebook Share Bert Shuttle Route Update on Twitter Share Bert Shuttle Route Update on Linkedin Email Bert Shuttle Route Update linkDue to construction along Old Hampden Avenue, Englewood’s free shuttle service through the Wellness District has been rerouted.Stop 8 has been temporarily rerouted to the northwest corner of Sherman Street and Old Hampden Avenue. Stop 13 has been temporarily rerouted to the southwest corner of Pennsylvania Street and Old Hampden Avenue. -
Construction Begins for Old Hampden Improvements
Share Construction Begins for Old Hampden Improvements on Facebook Share Construction Begins for Old Hampden Improvements on Twitter Share Construction Begins for Old Hampden Improvements on Linkedin Email Construction Begins for Old Hampden Improvements linkThe City of Englewood is excited to announce the official start of the improvements on Old Hampden in the Wellness District.
Starting Monday, January 6, 2025, crews will begin critical utility upgrades along Old Hampden Avenue, kicking off a two-phase project that will enhance the infrastructure and streetscape of this important corridor.
The first road closure will impact E. Hampden Avenue between S. Pennsylvania Street and S. Grant Street. This section of road will be closed to through traffic as crews begin the utility work. Detours will be in place to help guide drivers around the closure. Please follow posted detour signs and allow extra time for your commute as work progresses. This closure is expected to last until late February. Afterward, rolling closures will continue along Old Hampden Avenue, moving toward S. Broadway. The sidewalk on the south side of Old Hampden will remain open for pedestrians throughout construction.
This closure marks the start of Phase 1, which will focus on upgrading underground water, sewer, and stormwater systems to ensure reliable service for the future. Phase 1 is expected to continue through Summer 2025.
What’s Next?
The Old Hampden Complete Streets Project will be completed in two phases:
- Phase 1 (January–Summer 2025): Underground utility upgrades, including the replacement of aging water, sewer, and stormwater systems.
- Phase 2 (Summer 2025–Summer 2026): Above-ground streetscape improvements, including ADA-compliant sidewalks, upgraded bus stops, and traffic-calming measures.
Subscribe to this page for the most up-to-date project information and street closure information. Thank you for your patience as we work to improve Old Hampden Avenue and create a safer, more accessible corridor for all who live, work, and visit Englewood.
Follow Project
Who's Listening
-
Phone 303-783-6855 Email mroman@englewoodco.gov -
Phone 303-762-2510 Email rgrafman@englewoodco.gov
Project Schedule
-
Utilities Construction
Old Hampden Improvements is currently at this stageJanuary 2025 - Winter 2026
-
Complete Streets Construction
this is an upcoming stage for Old Hampden ImprovementsSpring 2026 -Spring 2027
Business Resources
Tools and information to support businesses throughout the construction process.
- Business Resource Toolkit
- Hampden Avenue Construction Impact Grant
The City of Englewood is now accepting grant applications of up to $5,000 for businesses experiencing economic hardship due to utility construction along Hampden Avenue. Learn more and apply here.
