South Broadway Public Realm Action Plan

Share South Broadway Public Realm Action Plan on Facebook Share South Broadway Public Realm Action Plan on X (formerly Twitter) Share South Broadway Public Realm Action Plan on Linkedin Email South Broadway Public Realm Action Plan link

Study Area

3.5 blocks of South Broadway, from Little Dry Creek to Eastman Avenue

Project Goals

Safer and Easier to Get Around
Improve the sidewalks and public areas around South Broadway, making them more attractive, safe, and accessible for everyone.

Distinctly Englewood
Honor our community’s traditional main street while highlighting its independent, creative vibe and diverse mix of local businesses.

Lively and Welcoming to All
Create a vibrant main street that invites people to explore, relax, and socialize. Boost local businesses by drawing in more customers, visitors, and investment.

Project Description

Sporting a colorful jumble of quirky shops, notable nightlife and one-off eateries, Downtown’s South Broadway serves as a place to mingle and linger as well as shop. A long history of self-made entrepreneurship has attracted businesses who think outside the box and visitors who seek authentic experiences in an unpretentious setting.

The South Broadway Public Realm Action Plan builds on our main street’s come-as-you-are character and welcoming nature. You’ll see improvements to sidewalks, crosswalks, and lighting that make the area more inviting, safe and accessible to all. You can look forward to creative elements that are both practical and attractive, like specialty lighting, seating, bike racks, native plantings, gateways and a new festival street.

Project Highlights

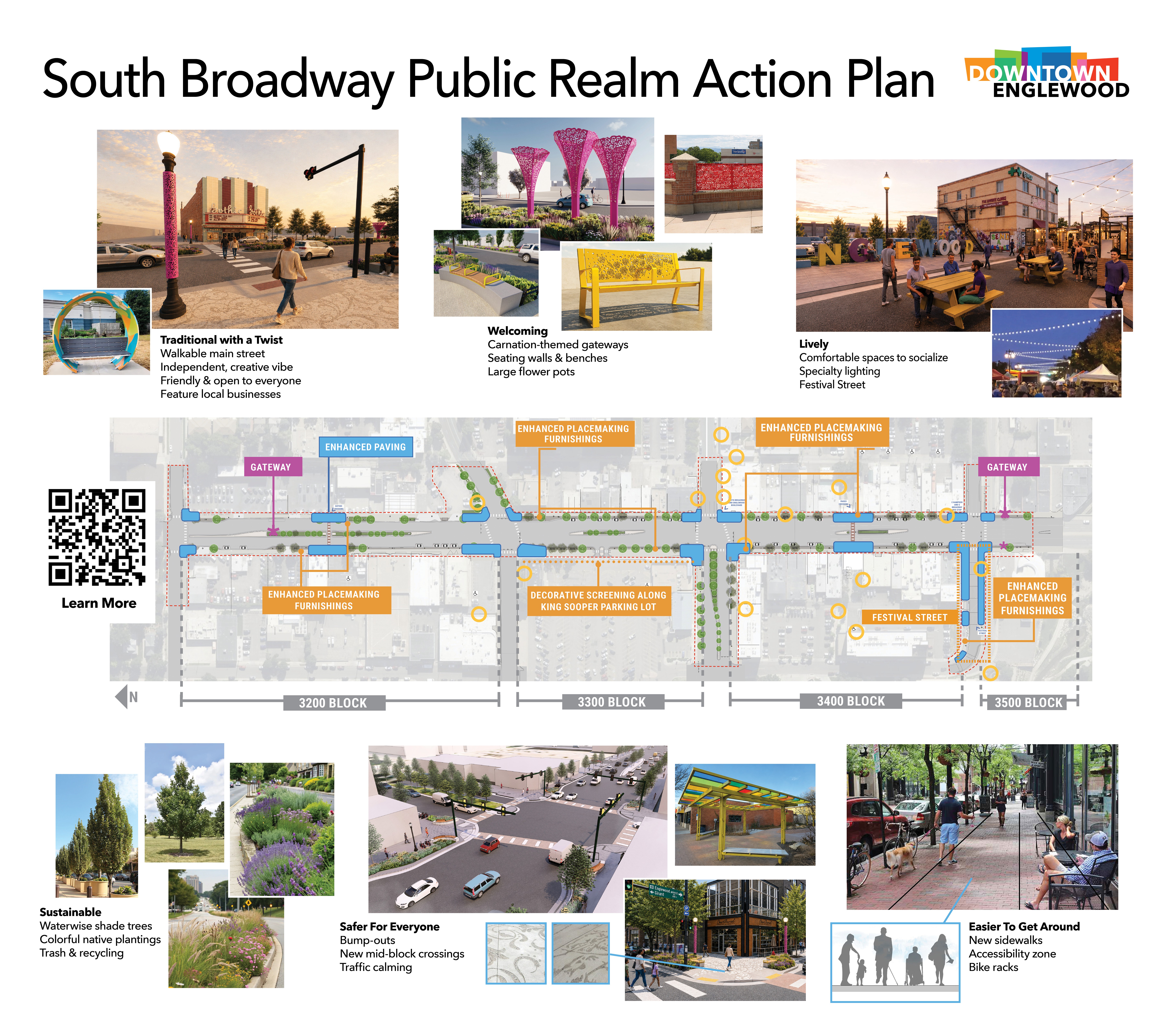

Project Map

Upon request, the city will make reasonable accommodations for alternative access to the map above. Submit the request here or call 303-762-2300.


Project Timeline

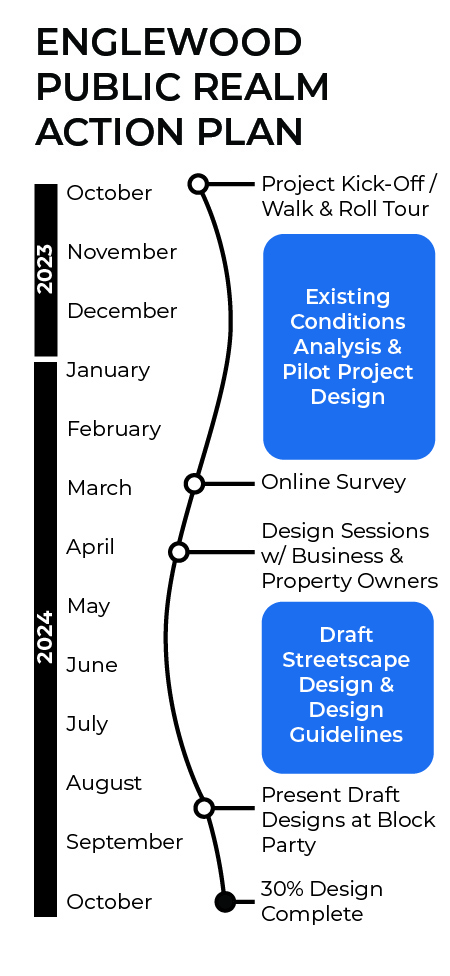

The project began in late 2023, with a community e-survey, small gatherings, pop-up events and demonstration projects through 2024. A conceptual plan was completed in 2024, and new design guidelines were adopted by the City of Englewood in 2025 to inform renovation of older buildings and context-sensitive new development. Now detailed planning is underway, with the goal to undertake improvements in 2027.

2026

  • 60% plan final May
  • Stakeholder updates May-July
  • 90% plan final July
  • Designs at Indiewood and Block Party
  • Construction documents, financing & implementation planning Sept-Dec

2025

  • Design guidelines development: Jan-April
  • City Council approval: May
  • Detailed planning underway: July

Upon request, the city will make reasonable accommodations for alternative access to the timeline above. Submit the request here or call 303-762-2300.

Study Area

3.5 blocks of South Broadway, from Little Dry Creek to Eastman Avenue

Project Goals

Safer and Easier to Get Around
Improve the sidewalks and public areas around South Broadway, making them more attractive, safe, and accessible for everyone.

Distinctly Englewood
Honor our community’s traditional main street while highlighting its independent, creative vibe and diverse mix of local businesses.

Lively and Welcoming to All
Create a vibrant main street that invites people to explore, relax, and socialize. Boost local businesses by drawing in more customers, visitors, and investment.

Project Description

Sporting a colorful jumble of quirky shops, notable nightlife and one-off eateries, Downtown’s South Broadway serves as a place to mingle and linger as well as shop. A long history of self-made entrepreneurship has attracted businesses who think outside the box and visitors who seek authentic experiences in an unpretentious setting.

The South Broadway Public Realm Action Plan builds on our main street’s come-as-you-are character and welcoming nature. You’ll see improvements to sidewalks, crosswalks, and lighting that make the area more inviting, safe and accessible to all. You can look forward to creative elements that are both practical and attractive, like specialty lighting, seating, bike racks, native plantings, gateways and a new festival street.

Project Highlights


Project Map

Upon request, the city will make reasonable accommodations for alternative access to the map above. Submit the request here or call 303-762-2300.


Project Timeline

The project began in late 2023, with a community e-survey, small gatherings, pop-up events and demonstration projects through 2024. A conceptual plan was completed in 2024, and new design guidelines were adopted by the City of Englewood in 2025 to inform renovation of older buildings and context-sensitive new development. Now detailed planning is underway, with the goal to undertake improvements in 2027.

2026

  • 60% plan final May
  • Stakeholder updates May-July
  • 90% plan final July
  • Designs at Indiewood and Block Party
  • Construction documents, financing & implementation planning Sept-Dec

2025

  • Design guidelines development: Jan-April
  • City Council approval: May
  • Detailed planning underway: July

Upon request, the city will make reasonable accommodations for alternative access to the timeline above. Submit the request here or call 303-762-2300.

Page last updated: 24 Jul 2026, 09:39 AM
